Shingle roof and flooded interior rebuilt after a hurricane

Hurricane winds took the roof and storm flooding gutted the main level of a waterfront home. One company rebuilt both: a full shingle re-roof over a re-nailed deck, then 568 feet of flood cut, 72 sheets of drywall, and a whole-home refinish. Told from the project record, with the client's details redacted.

At a glance

The shape of this job

The short version, before the narrative: what was installed, what the roof was, and how the decision was settled.

System installed
TAMKO Titan XT laminated shingles, six nails each, over ice and water shield across the entire deck
Roof type
Asphalt laminated shingle
Service line
Roof replacement and interior flood restoration
Market
Treasure Island, FL
Scale
43 squares ordered; 3,989 sq ft of deck re-nailed

Problem

On September 26, 2024, hurricane winds tore into the shingle roof of a single-story waterfront home and the same storm pushed flooding through the entire main level. Every room took water.

Decision

The roof came first: tear-off, a complete re-nail of all 3,989 square feet of sheathing, and ice and water shield across the whole deck as the secondary water barrier. The interior followed under the same company, with a 4-foot flood cut through every room before rebuild.

Result

TAMKO Titan XT shingles fastened with six nails each, mastic at the eaves, rakes, valleys, and gable ends, and the 224 feet of seamless gutters reinstalled intact rather than replaced. Inside: 568 linear feet of flood cut, 72 sheets of drywall, a rebuilt kitchen, ten new interior doors, new vanities and trim, and prime and paint through the whole home. The roof's Certificate of Completion was signed February 26, 2025.

Treasure Island, FL · From the file

The job on record

Each fact below comes from the underlying project record: measurement reports, material orders, written scopes, dated photographs, completion paperwork, or an owner-attested narrative.

Shingles ordered
43 squares
Flood cut
568 linear ft, every room
New drywall
72 sheets
Deck re-nail
3,989 sq ft
Roof completion certificate
Feb 26, 2025
Job file
34 documents, 424 pages

What happened

On September 26, 2024, hurricane winds tore into the shingle roof of a single-story waterfront home in Treasure Island. The same storm pushed flooding through the entire main level. Every room took water.

The roof was not old. The job file holds the city permit record showing it had been rebuilt in 2021 with 40-year dimensional shingles, about three years before the storm.

What we did

The roof came first. Tear-off, a complete re-nail of all 3,989 square feet of sheathing, ice and water shield across the entire deck as the secondary water barrier, then TAMKO Titan XT laminated shingles fastened with six nails each. Mastic went down at the eaves, rakes, valleys, and gable ends per Florida's high-velocity hurricane zone application standards. The 224 feet of seamless gutters came off carefully and went back on intact instead of being replaced.

Then the interior. A 4-foot flood cut through every room, 568 linear feet of it. Seventy-two sheets of new drywall, a rebuilt kitchen, ten new interior doors, new vanities and trim, and prime and paint through the whole home. The finish work included three-coat Venetian plaster tied into the plaster that survived, and the stone fireplace was deep cleaned and re-glazed.

The licensed electrical, plumbing, and HVAC trades were coordinated under our general contractor license: new devices and boxes where needed, a new water heater, and two coastal-coated air conditioning systems with the condensing units strapped to new braces per hurricane wind requirements.

What it took

This home sits in a coastal floodplain, so the rebuild ran through the City of Treasure Island storm-repairs permit process: FEMA substantial-improvement cost breakdown worksheets, a project value affidavit, and signed verification forms for every trade.

Every phase went into dated photo reports: the damage, the tear-off, the dry-in, the finished roof from the air. The roof's Certificate of Completion was signed February 26, 2025, and the interior restoration carried through to its final invoice in August 2025.

Sequence on record

How the work ran

Each milestone below comes from a document, dated photograph, or owner-attested project record.

  1. Sep 26, 2024

    Hurricane winds damage the shingle roof; storm flooding fills the entire main level.

  2. Sep 30, 2024

    Aerial roof measurement report produced.

  3. Oct 3, 2024

    Roof work authorized; Florida required contractor notices delivered and acknowledged.

  4. Dec 3, 2024

    Roof materials ordered: TAMKO Titan XT shingles, 43 squares.

  5. Feb 2025

    Tear-off; the pre-existing peel-and-stick membrane on the deck is photo-documented.

  6. Feb 26, 2025

    Roof finished; Certificate of Completion signed.

  7. Mar 2, 2025

    Owner authorizes the interior restoration.

  8. May 21, 2025

    Interior scope signed: drywall, kitchen, doors, vanities, trim, paint.

  9. Aug 4, 2025

    Final interior invoice issued.

From the job

The job in photographs

Photographs from the job's own documentation, in work order. Details that could identify the client or the property are cropped or blurred.

Before

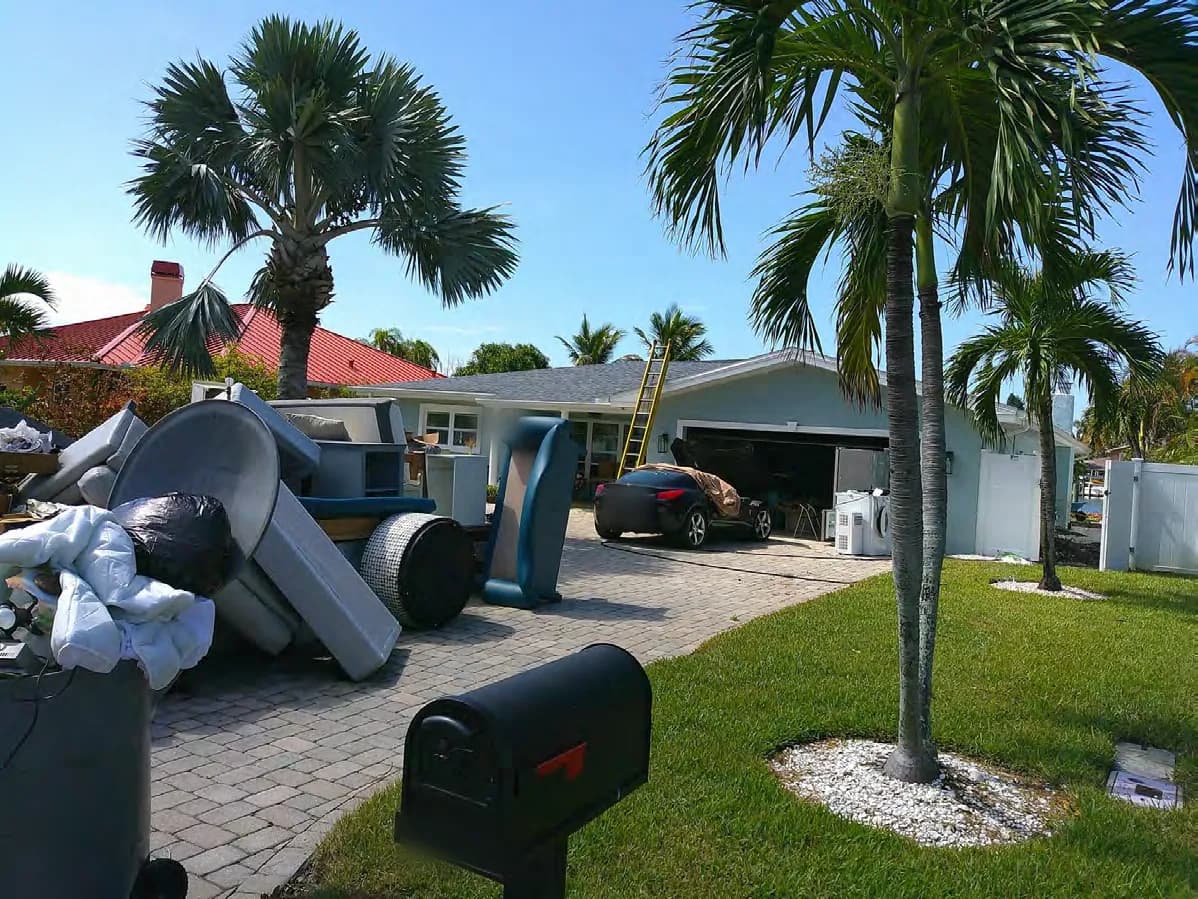

Water-damaged furniture and belongings piled at the curb of a single-story home, with a ladder set against the roof and the garage standing open.
Two losses in one frame: the flooded interior at the curb, the inspection ladder already on the wind-damaged roof.

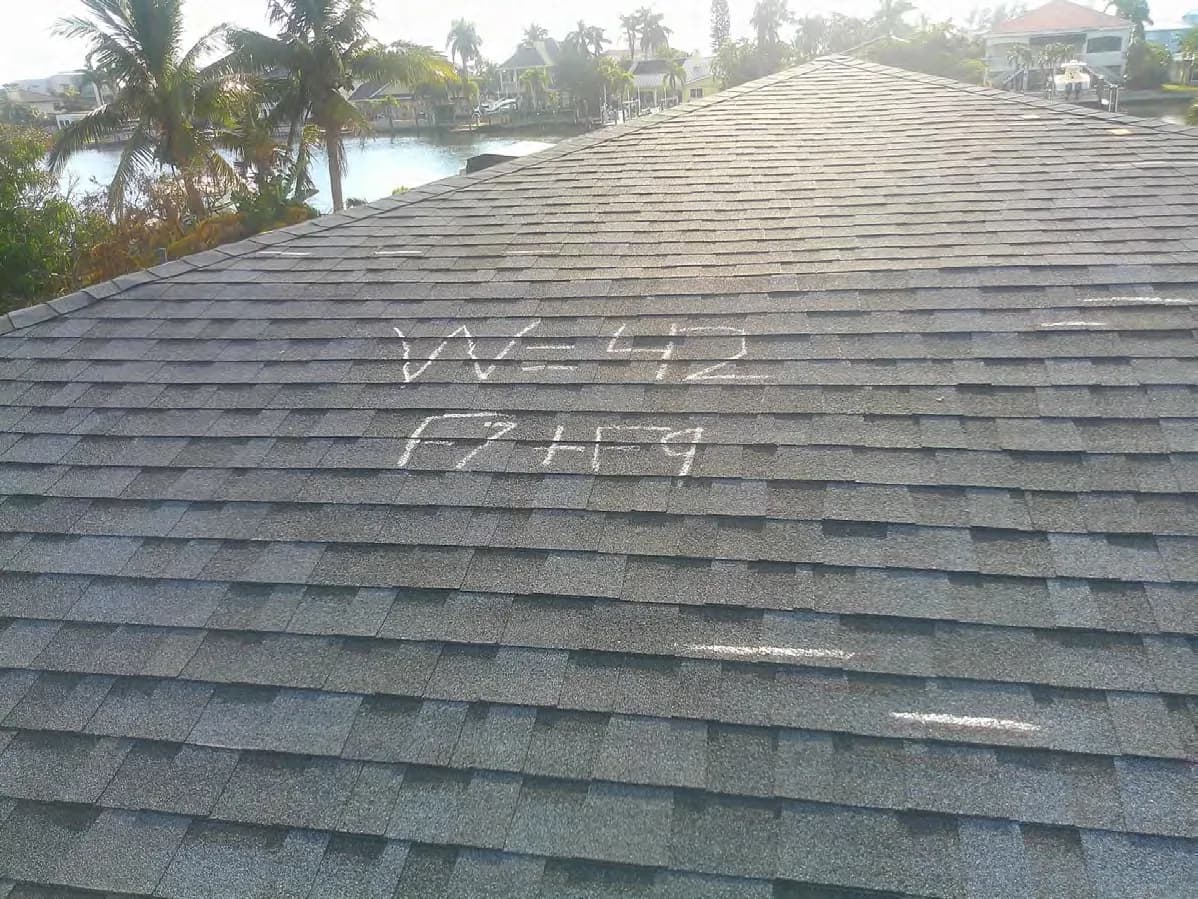

Grey shingle roof slope with a wind-damage tally written in chalk on the shingles and a canal behind the house.
The inspection chalk stayed on the roof: wind damage tallied slope by slope.

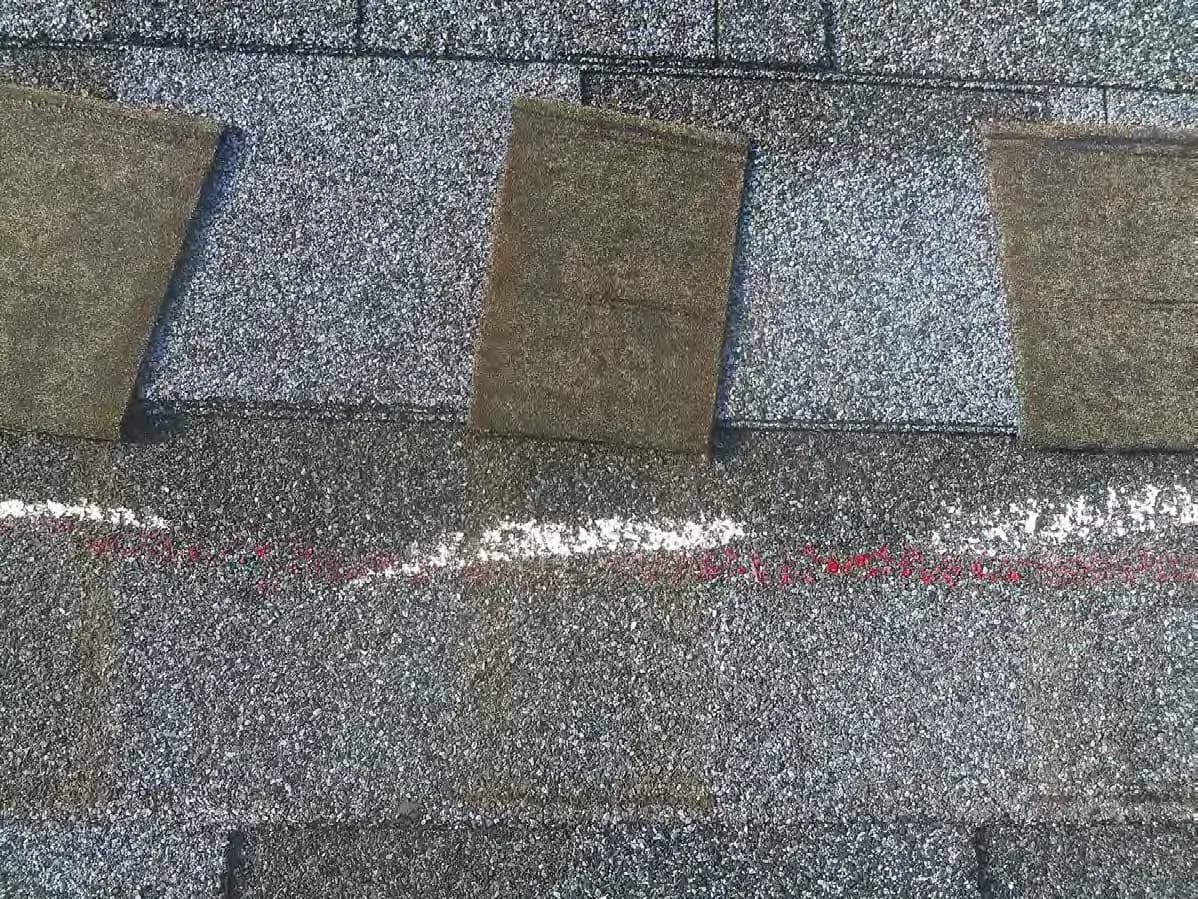

Close-up of lifted, creased shingle tabs above a line of white and red inspection chalk.
Creased and displaced tabs, marked at close range during the damage inspection.

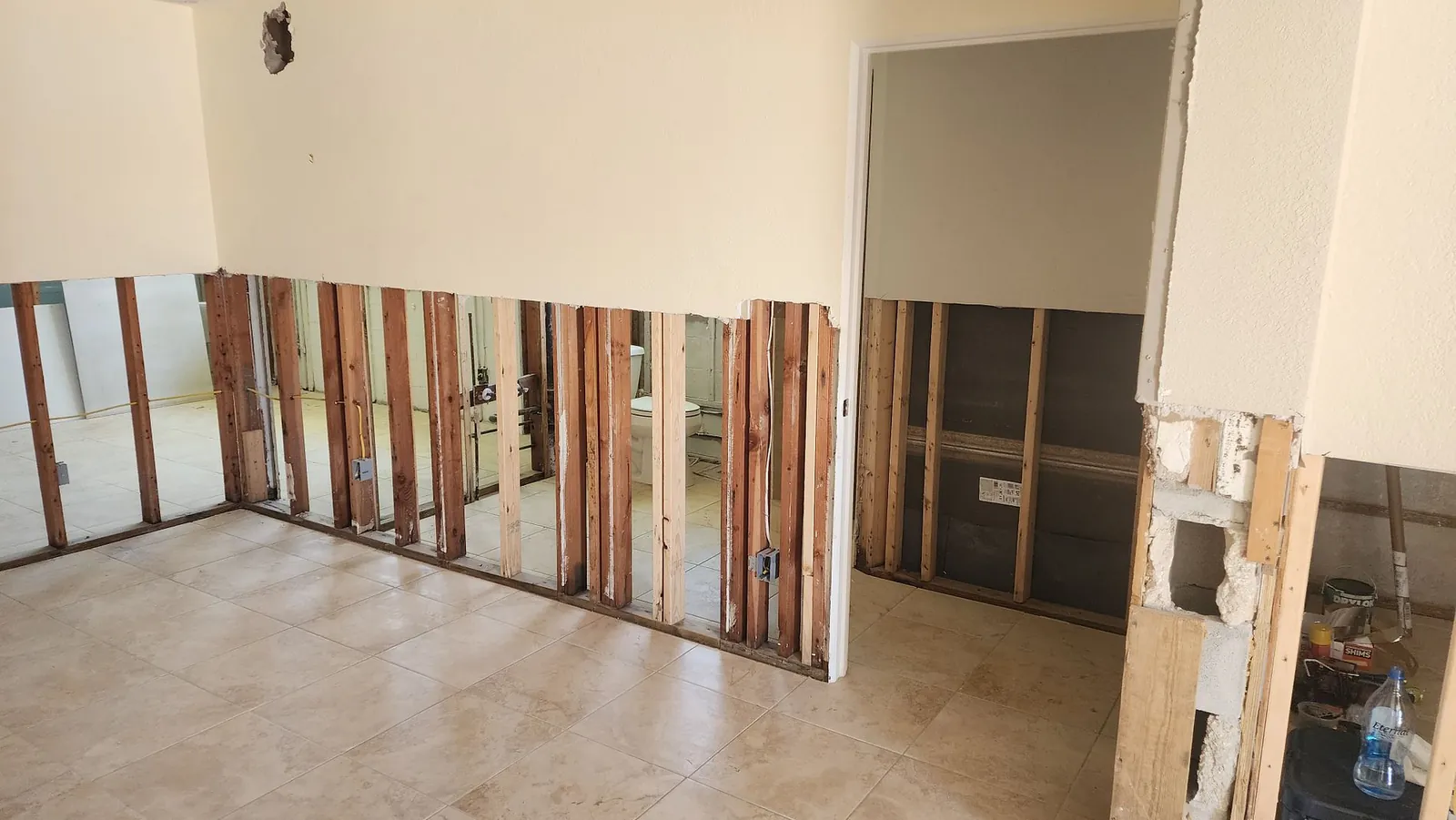

Interior room with the lower four feet of drywall removed to bare studs on every wall, tile floors exposed, and a bathroom visible through the open framing.
The 4-foot flood cut ran through every room on the main level: 568 linear feet of opened walls.

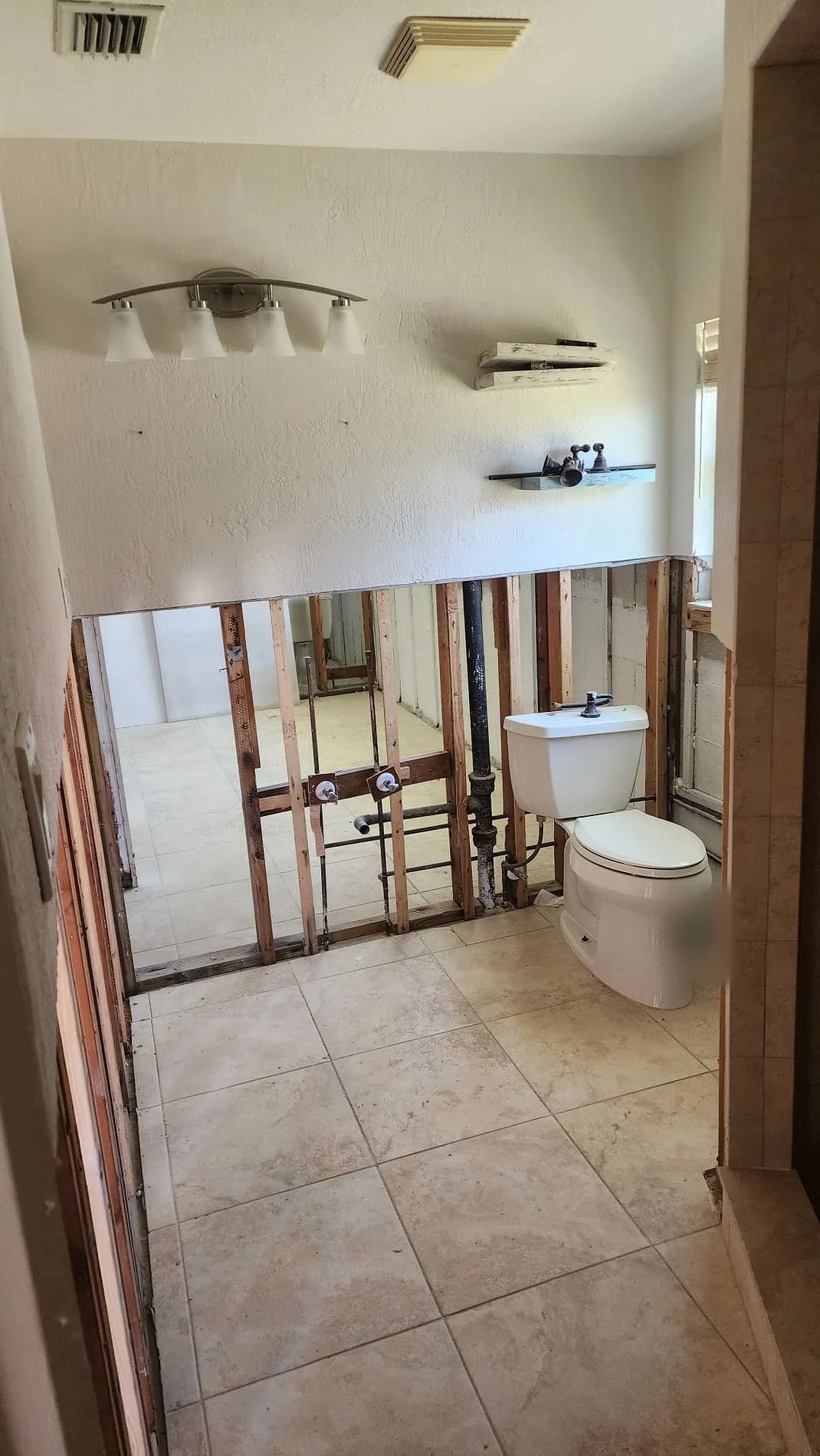

Bathroom with the lower wall cut away to the framing around the toilet, supply plumbing exposed, and the vanity light still mounted above.
The flood line did not skip the baths: walls opened around the fixtures and plumbing.

During the work

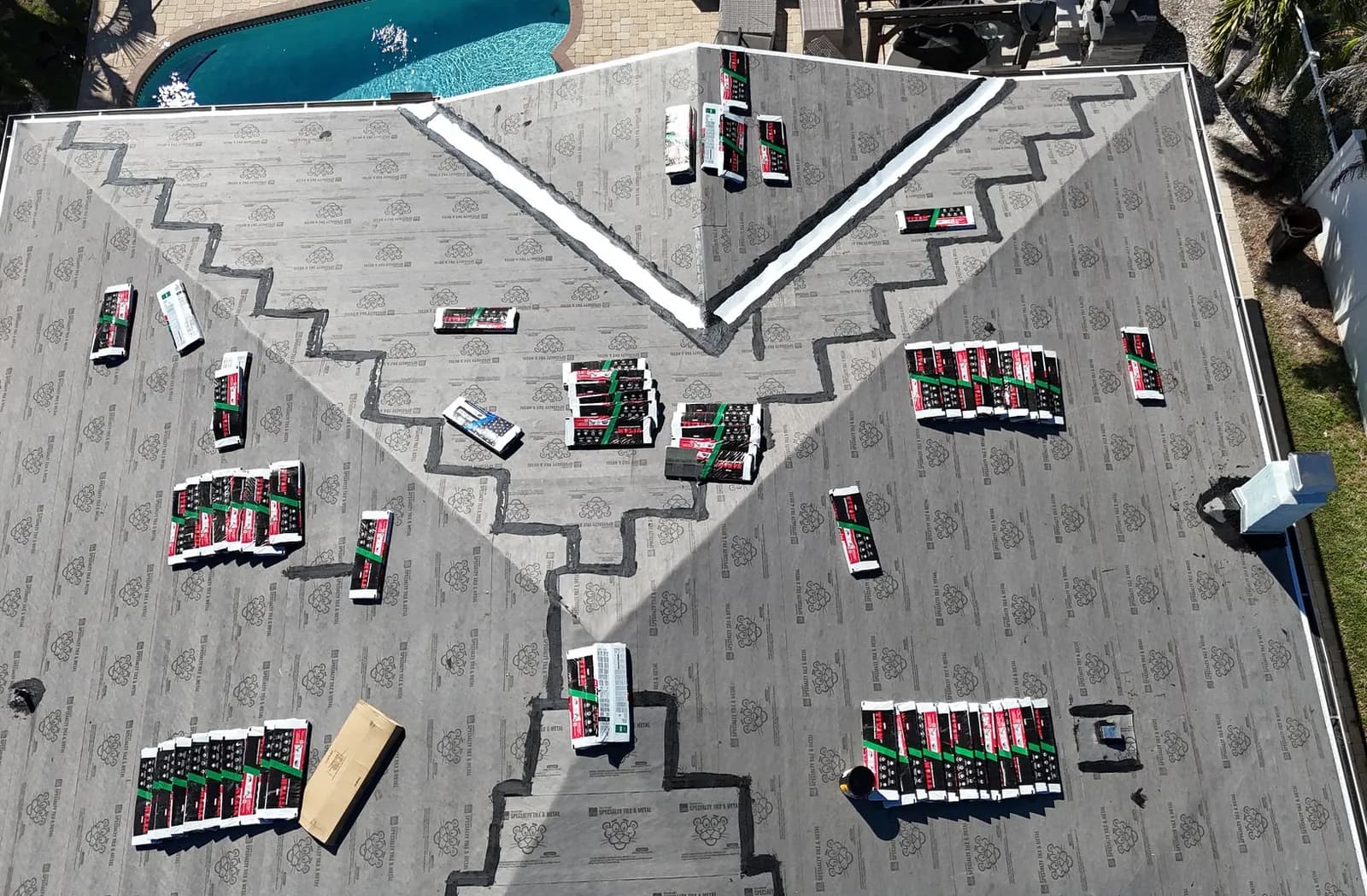

Aerial view of a hip roof fully dried in with grey underlayment, seams taped and sealed, shingle bundles staged across the slopes, and a pool beside the house.
Dry-in, documented from the air: ice and water shield across the entire deck and bundles staged before the first shingle went on.

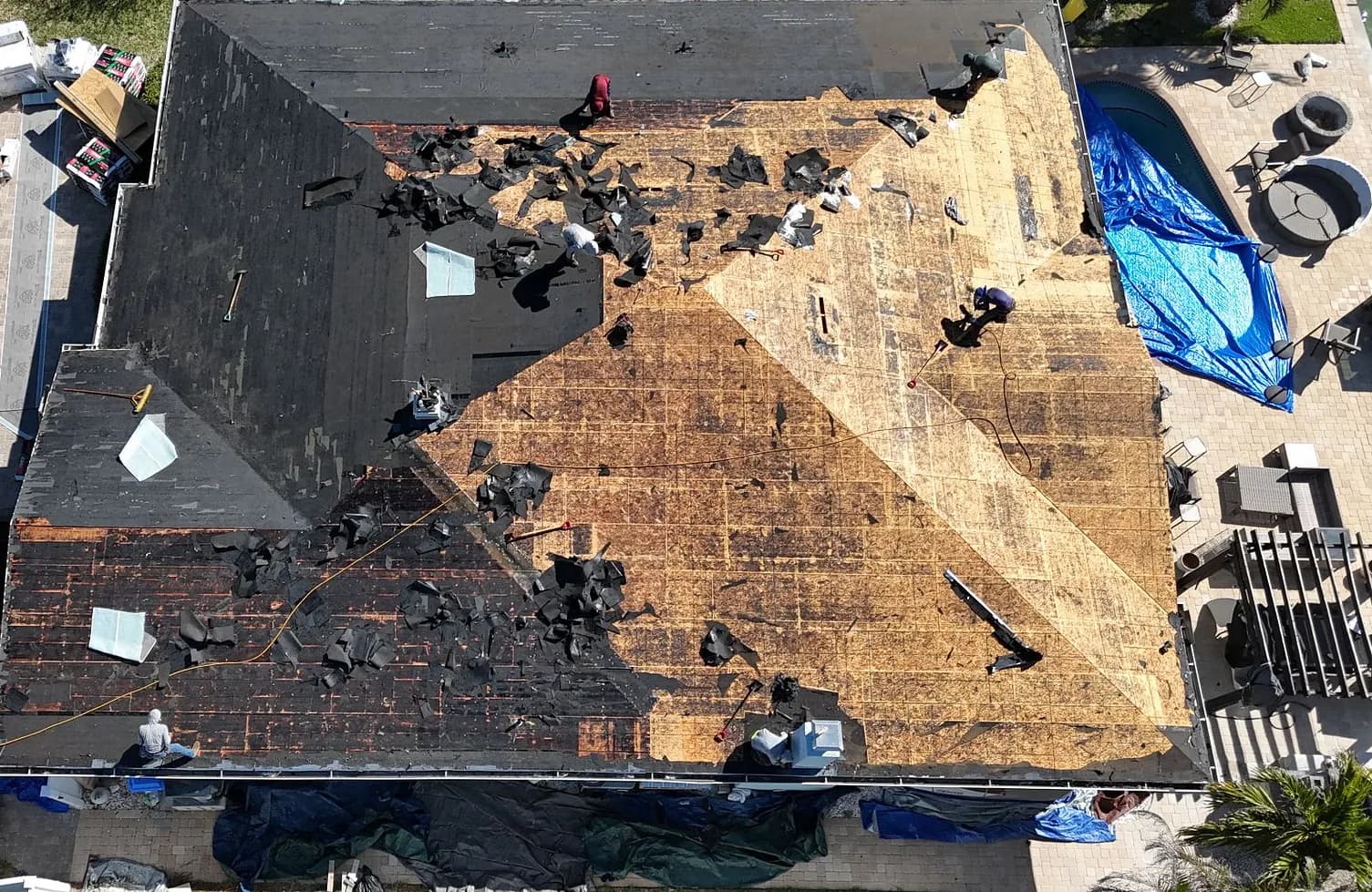

Aerial view of the roof mid-tear-off, one side stripped to bare sheathing, crew members working on the slopes, and tarps protecting the ground below.
Tear-off from the air. Each phase of the roof went into its own dated photo report.

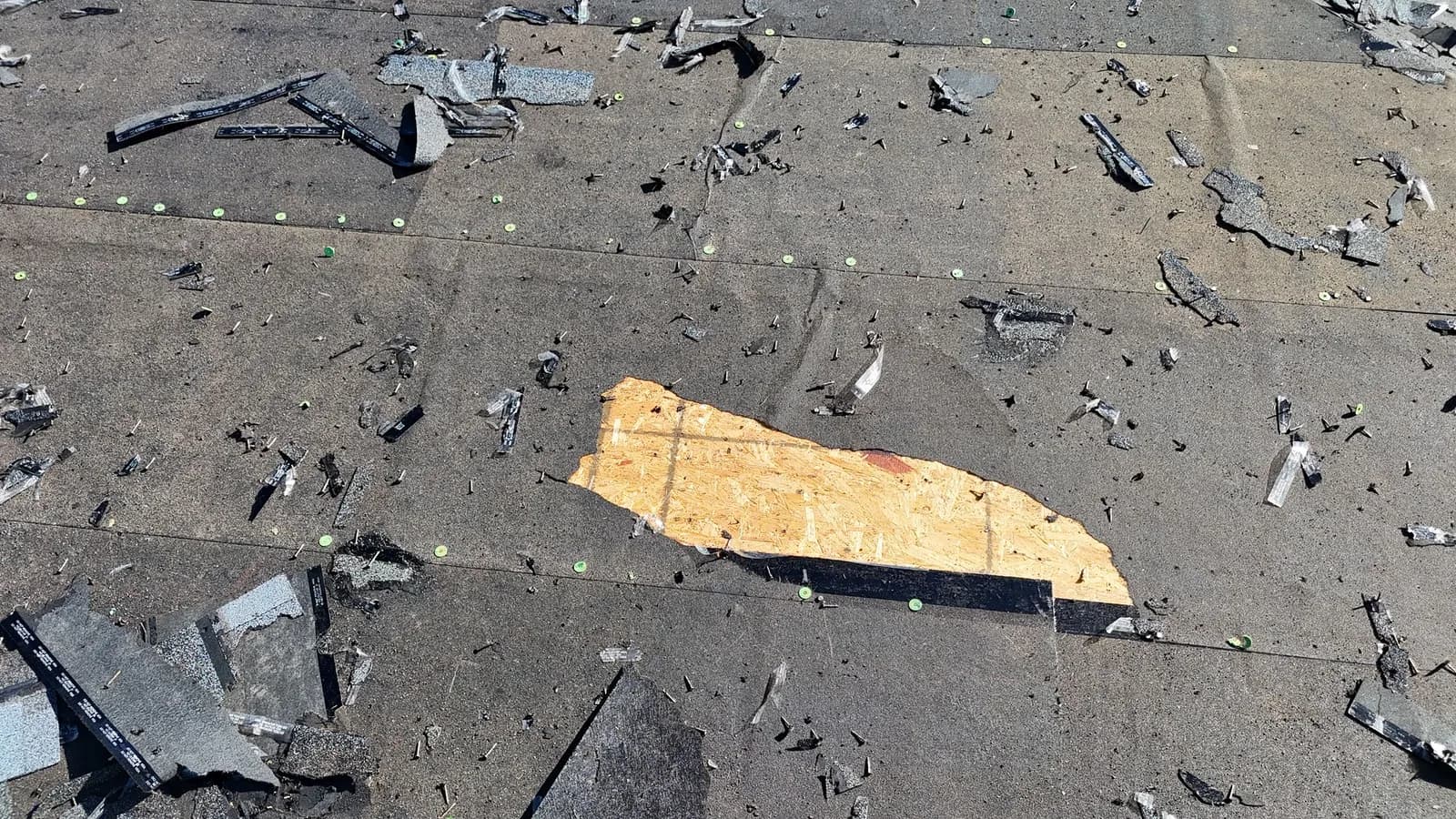

Roof deck at tear-off still covered by an older peel-and-stick membrane with cap nails, one patch of bare sheathing exposed, and shingle debris scattered across it.
What tear-off exposed: the previous roof's peel-and-stick membrane bonded to the deck, photographed as its own deliverable because it drove the sheathing scope.

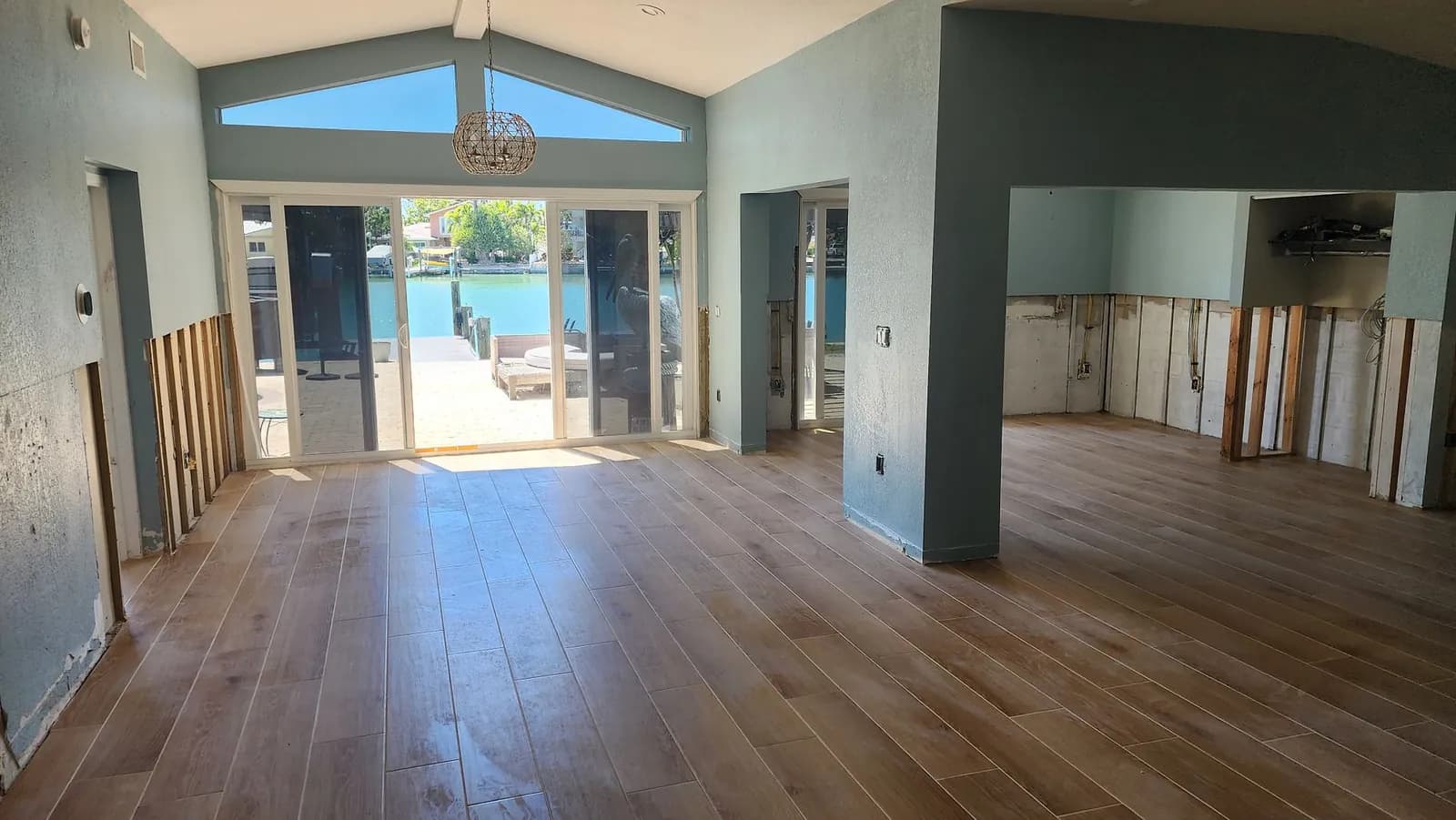

Open living space with new plank flooring installed, the base of the walls still open from the flood cut, and sliding glass doors looking out to a patio, dock, and canal.
Mid-restoration: new plank floors down, the flood cut still open, the canal beyond the sliders.

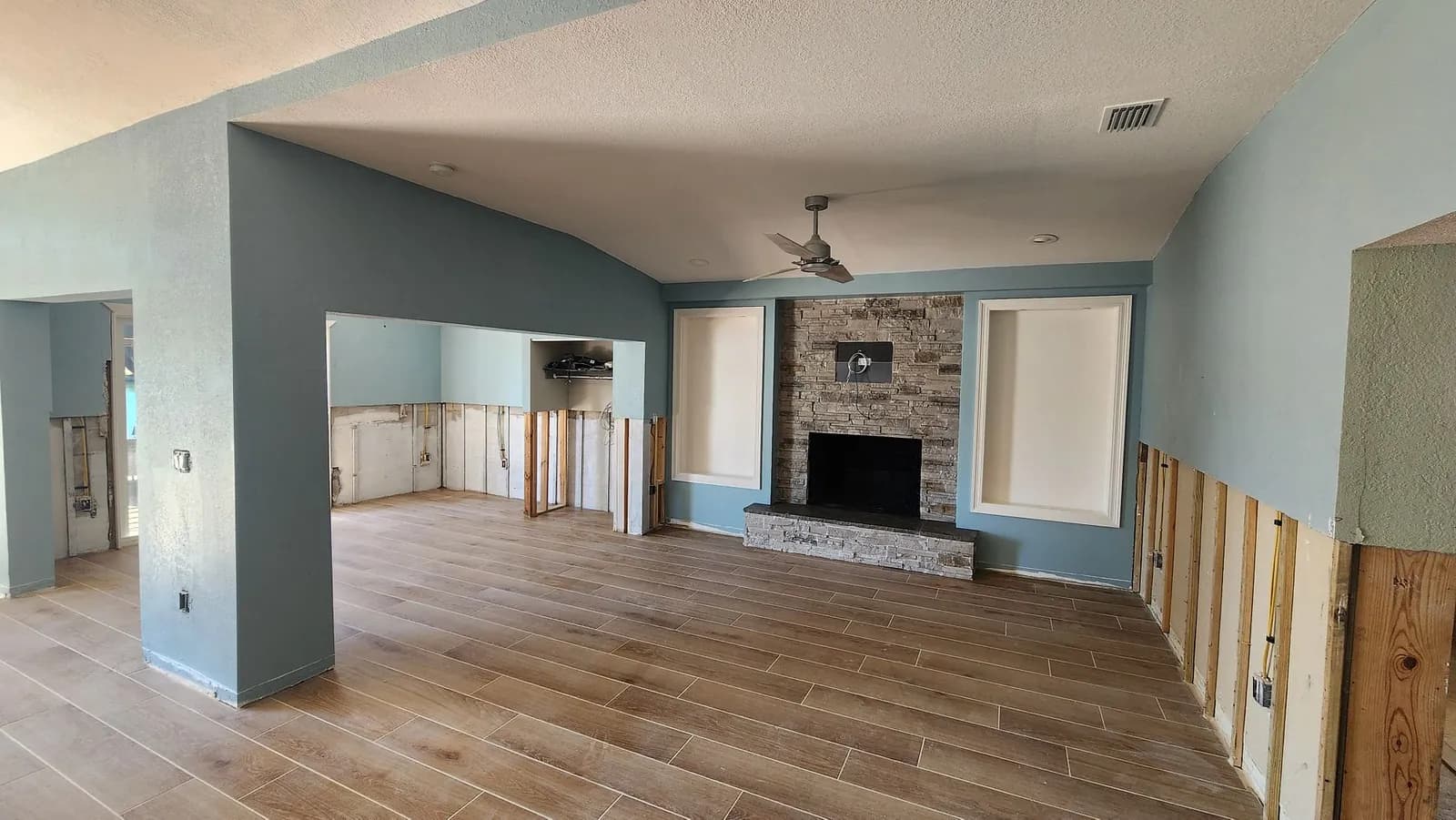

Living room mid-restoration with fresh paint and new plank flooring, a stacked-stone fireplace at center, and the lower walls still open to the framing.
Paint and floors in, lower walls awaiting drywall, the stone fireplace ready for its re-glaze.

Finished

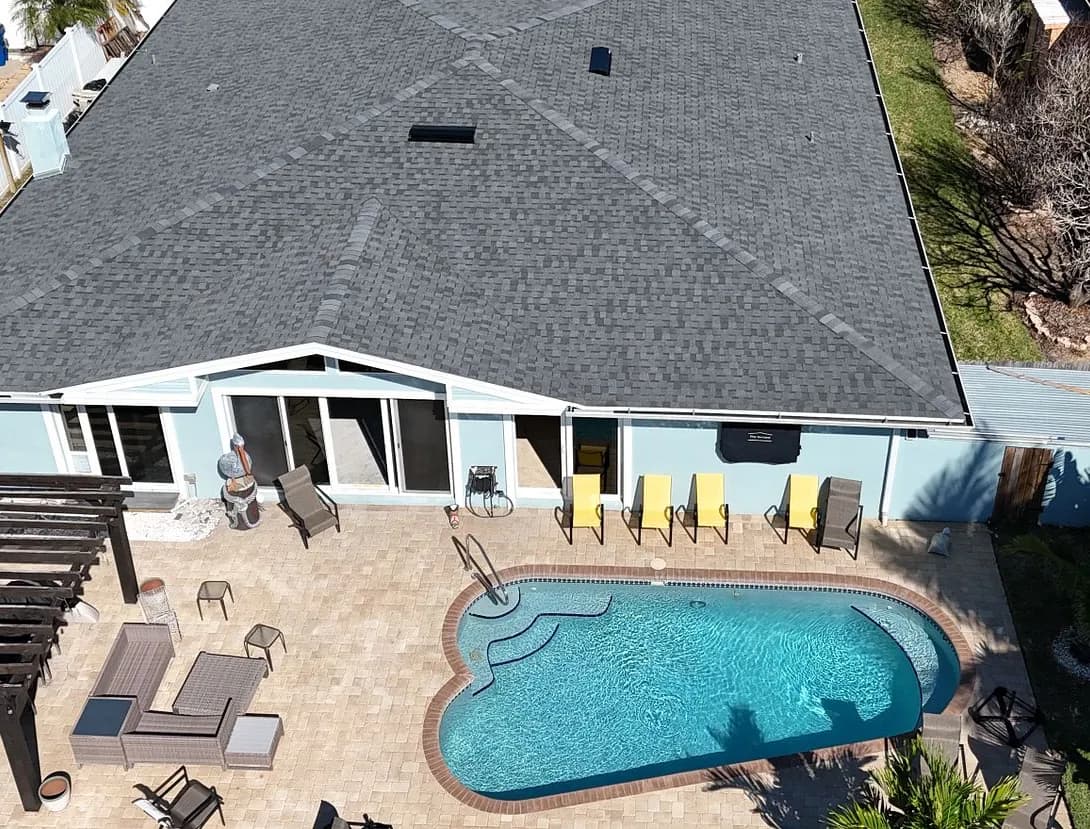

Aerial view from behind the house showing the finished charcoal shingle roof over the rear patio and pool.
Finished: TAMKO Titan XT shingles over a fully re-nailed deck, six nails per shingle, photographed by drone at completion.

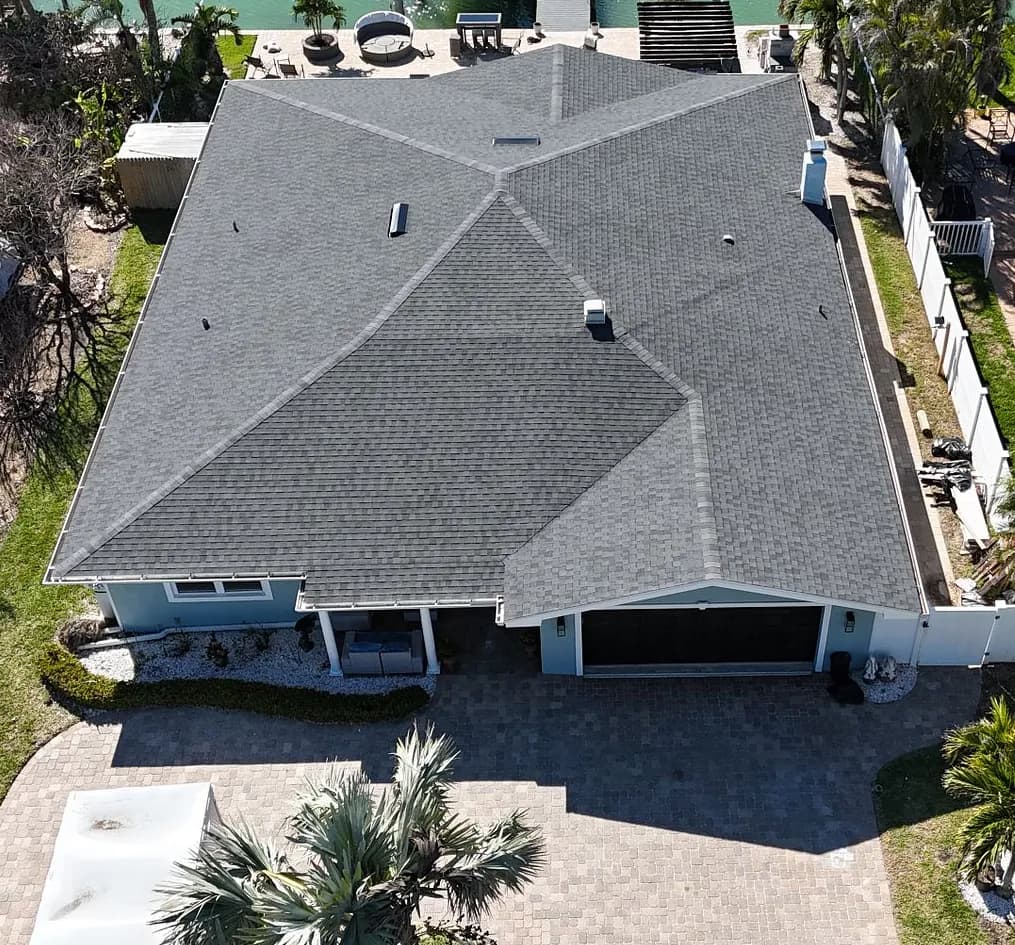

Overhead aerial of the completed hip roof in charcoal shingles, with the driveway in front and the canal and dock behind the house.
The file closed the way it opened: the whole roof documented from the air.

The paperwork

Documents from the file

Shown as delivered, with the client's details blacked out. Black bars are the redactions; everything else is untouched.

Certificate of Completion, February 26, 2025
Certificate of Completion on K. Simon Construction letterhead dated February 26, 2025, with black redaction bars over the owner information lines and the signature.

Blacked out: the customer's name, the job address and city lines, and the project manager's signature and printed name. The date, the re-roof project description, and the license numbers are as issued.

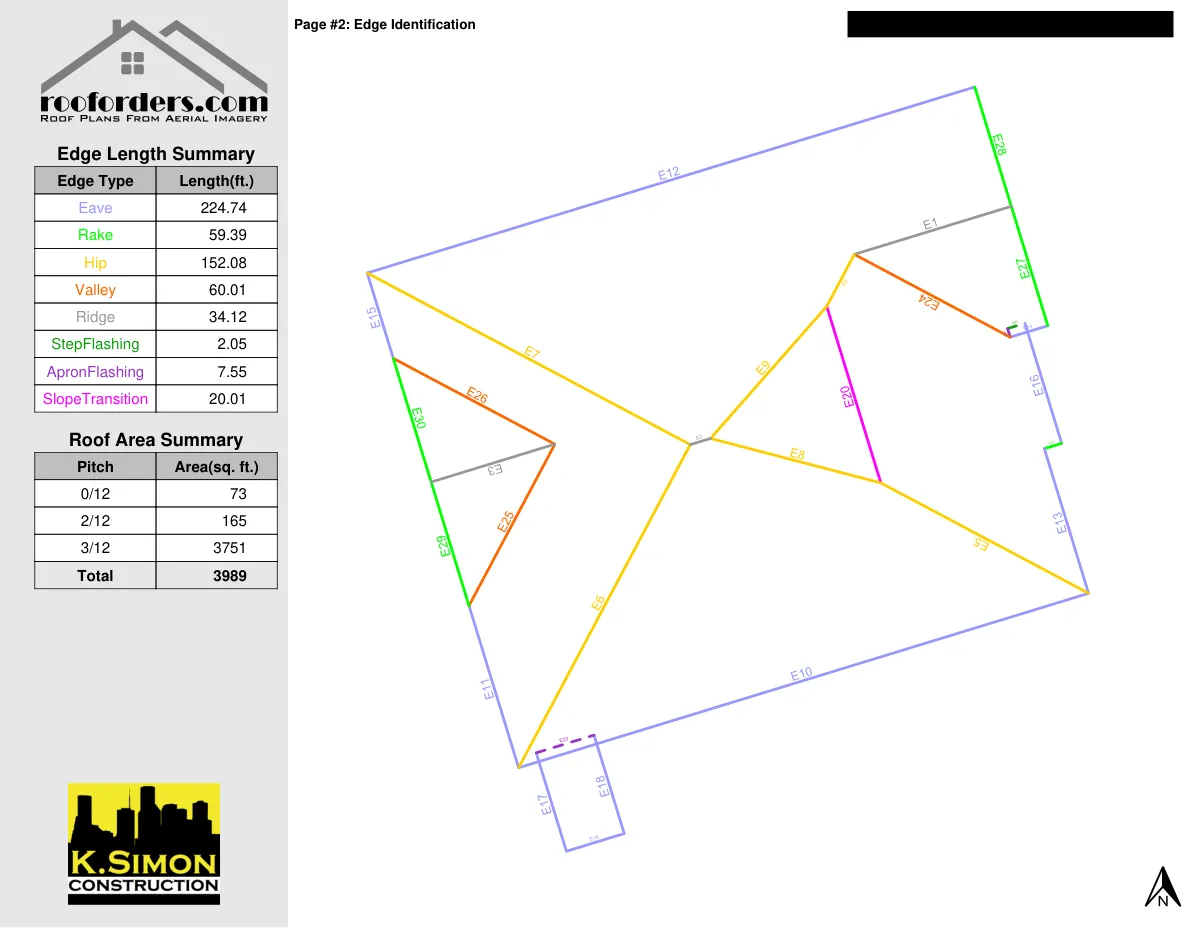

Aerial measurement report, edge identification page
Aerial roof measurement report page with a color-coded edge identification diagram and tables listing edge lengths by type and roof area by pitch.

Blacked out: the property address in the page header. The diagram, the edge length table, and the pitch table are as delivered.

Where this comes from

One job, one file

Built from the owner-supplied job file for this project. The evidence record was prepared July 14, 2026, and every fact on this page traces to a document or dated photograph in that file.

What you will not find here: the client's name or address, claim or policy numbers, the insurance company, dollar amounts, or how anything went with insurance. That stays the client's business.

See the other case studies

What this job answers

The questions a job like this settles

Every answer below is drawn from the record on this page. Nothing here predicts what your roof will need; it shows how these questions were settled on one documented job.

Do the roof and the inside need two different contractors?
Not here. One company carried the job from the roof through the interior finish, coordinating the licensed electrical, plumbing, and HVAC trades under our general contractor license: new devices and boxes where needed, a new water heater, and two coastal-coated air conditioning systems with the condensing units strapped to new braces per hurricane wind requirements.
My roof is only a few years old. Could it really be damaged?
This one was. The job file holds the city permit record showing the roof had been rebuilt in 2021 with 40-year dimensional shingles, about three years before the storm. The wind damage was tallied slope by slope in inspection chalk and photographed at close range: lifted, creased tabs above the chalk line.
What does a coastal floodplain rebuild take on paper?
This home sits in a coastal floodplain, so the rebuild ran through the City of Treasure Island storm-repairs permit process: FEMA substantial-improvement cost breakdown worksheets, a project value affidavit, and signed verification forms for every trade.
Do the gutters survive a re-roof?
These did. The 224 feet of seamless gutters came off carefully and went back on intact instead of being replaced.
